Transportation

Alaska’s summer ferry schedule is open for booking

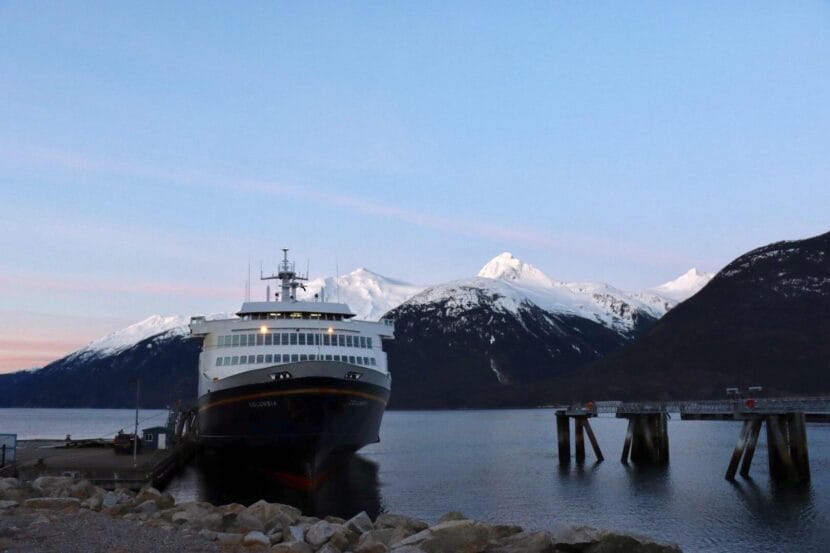

A docked Alaska state ferry with snowy mountains in the background, across a body of water.
The Columbia, a mainliner in the Alaska Marine Highway System, docked in Skagway in early March, 2025. (Avery Ellfeldt/KHNS)

Travelers can now schedule ferry rides with the Alaska Marine Highway System for May through September. That’s after the summer schedule opened for booking Feb. 12.

The schedule looks a lot like recent years, with six of the state’s nine vessels sailing. There is not enough funding or staffing to run them all, said Shannon McCarthy, spokesperson for the state Department of Transportation.

“Our crew is relatively stable right now, but, you know, it’s not expanding rapidly,” McCarthy said. “Our budget is also a concern this year, so we will only be running one of the mainliners at any given time.”

Only one mainliner – the Columbia – is scheduled to travel weekly through Southeast to Bellingham, Washington. That means a round trip every two weeks for most residents.

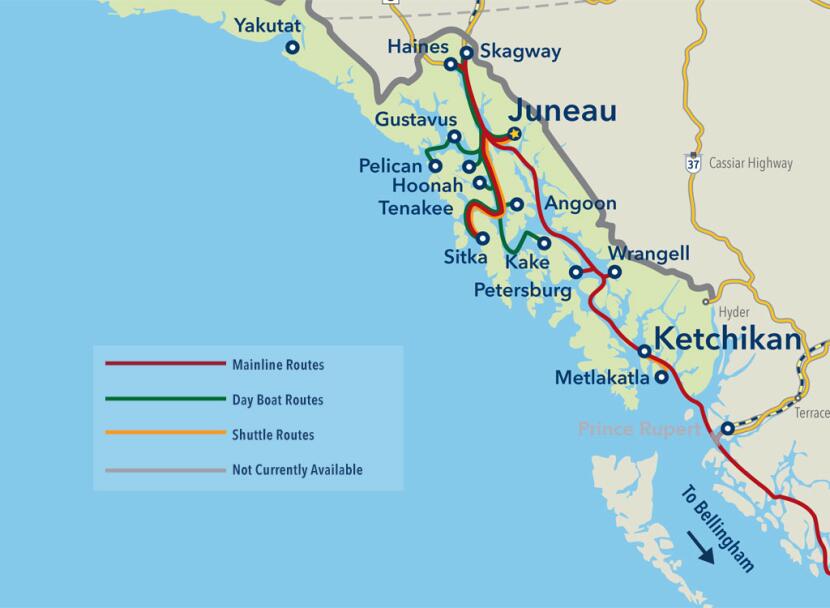

A map of the Alaska Marine Highway System’s routes in Southeast Alaska. (Alaska Dept. of Transportation and Public Facilities)

McCarthy said the Kennicott will be on standby in case the Columbia needs repairs.

“The nice thing is, it is much better to have two vessels — main liners — that are able to be sailed at any point,” she said. “It puts the state in a much better position.”

The Tustumena will sail the southwest region between Homer and the Aleutians. That’s roughly two round trips per week from Homer to Kodiak, and one full Aleutian Chain run per month.

The day boat, Leconte will sail Prince William Sound. And Lynn Canal will be similar to last year, with the Hubbard doing nearly daily runs between Juneau, Haines, and Skagway.

U.S. Senator Lisa Murkowski helped secure hundreds of millions in federal ferry funds over the last five years. But the state is now waiting on a key federal grant for this year. DOT Commissioner Ryan Anderson is scheduled to be in DC this week to talk to the Alaska Delegation about it.

“Because this money is still available — it was written into the law,” McCarthy said. “So, we’re just trying to figure that out, to see if there is some relief there.”

With ongoing funding issues, the state is considering selling the Matanuska, a 63-year-old mainliner that’s been tied up in Ketchikan and used for housing new ferry workers. McCarthy says they’ll still be able to offer housing in the mainliner that’s not currently sailing.

Alaska Marine Lines, ferry system staff discuss options for safely transporting electric vehicles to Southeast Alaska

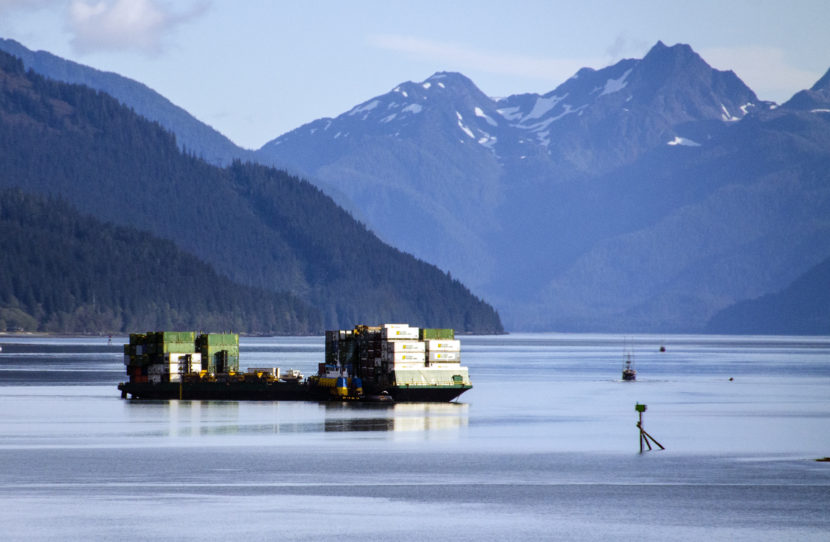

A barge departs from the Alaska Marine Lines dock in downtown Juneau.
A barge departs from the Alaska Marine Lines dock in downtown Juneau. (Heather Bryant/KTOO)

Staff from Alaska Marine Lines and the Alaska Marine Highway System discussed EV shipping safety during a panel held by Renewable Juneau, an advocacy nonprofit, on Wednesday.

Electric vehicles have grown in popularity in Juneau over the years, but shipping safety concerns have now made it more difficult for people to bring them to Alaska or send them out for maintenance.

AML stopped shipping electric vehicles to Alaska last year due to the fire risk posed by lithium ion batteries. The decision came after another company’s cargo ship carrying hundreds of hybrid and electric vehicles caught fire in the open ocean off the coast of Adak, burned for days and sank. An AML spokesperson said at the time the company would reassess its policy as industry standards improve.

During the panel, AML President Don Reid said he wished there were reliable safety ratings for the various lithium ion batteries on the market.

“Every manufacturer you talk to wants to tell you that their product is perfectly safe,” Reid said. “And, you know, who are you supposed to believe?”

Reid said he wants AML to be able to ship all vehicles, but he’s spent a lot of time researching the issue and speaking with consultants, and said that shipping EVs that plug-in would be too risky for the company at this point.

“What I need is the confidence that the thing’s not going to catch on fire on the barge. That’s really what it comes down to,” Reid said.

AML was the last barge company to pull EVs off its Alaska shipping routes after Matson and Tote Maritime. Now, EVs can be shipped two ways: on the road system, which doesn’t extend to much of Southeast, or two-at-a-time on the ferry — creating a bottleneck for consumers.

Craig Tornga, marine director for the Alaska Marine Highway System, said people who want to ship an EV on the ferry from Bellingham might wait around three months.

To improve safety procedures, the agency hired a vessel firefighter with expertise in EV battery fires. The procedures include recommending EV drivers not charge the battery too much before boarding, placing EVs in areas of the ship easy for firefighters to access and repeatedly inspecting the vehicles while in transit.

“We have thermal infrared handheld cameras,” Tornga said. “We go around and we — every hour, on the hour — we shoot the battery to see what the temperature is and make sure we don’t see any changes.”

In addition to the handheld cameras, the ferry system plans to install other thermal cameras and purchased high-powered sprayers called Turtle Fire Systems that can flood a battery box to cool it down.

Disclaimer: The panel was hosted at KTOO, with staff outside the news department contracted to produce the event.

Alaska lawmakers grill transportation officials over controversial ferry project

Rep. Louise Stutes, R-Kodiak, questions officials from the Department of Transportation and Public Facilities during a House Transportation Committee meeting in Juneau on Feb. 10, 2026.
Rep. Louise Stutes, R-Kodiak, questions officials from the Department of Transportation and Public Facilities during a House Transportation Committee meeting in Juneau on Feb. 10, 2026. (Eric Stone/Alaska Public Media)

Members of the House Transportation Committee slammed state transportation officials on Tuesday over a controversial ferry project that lawmakers said stands to benefit private interests but not ferry users themselves.

“The Alaska Marine Highway System was created for Alaskans — not for DOT — but for people and their usage. And you know, I don’t like to see you lose sight of that,” Rep. Louise Stutes, R-Kodiak, said during the hearing,

At issue is the Cascade Point ferry terminal project. The Alaska Department of Transportation signed a $28.5 million dollar contract over the summer to kickstart the effort, which aims to shorten the ferry route between Juneau, Haines and Skagway.

The project would entail building a ferry terminal 30 miles farther north of Juneau than the current one in Auke Bay. That means passengers would have to drive or use a shuttle service to travel between the remote terminal and town.

The contract ignited a wave of opposition from people in all three communities during a public comment period. During the hearing, Stutes noted that the vast majority of the more than 600 public comment letters opposed the project.

“92% of the people said, ‘We don’t want Cascade Point,'” Stutes said.

The pushback has largely centered around concerns that the new terminal would make regional travel less convenient and efficient – as opposed to more, as the state has argued. People have also argued the funds would be better spent on improving existing ferry service.

Christopher Goins is DOT’s southcoast region director. During the hearing, he acknowledged that the numbers Stutes cited are correct and that the project has sparked a lot of “fear” in the public.

But he added that the agency is taking public feedback seriously. He said that includes extending the original comment period and planning two additional rounds of public meetings in Haines, Skagway and Juneau.

“My staff is going to sit there, and we are going to listen to what people have to say, because we want them to be able to put that on the record,” Goins said. “That is fair and that is just. I think this project, of all the projects, needs that process.”

Goins acknowledged public concern over the state’s decision to move forward with the initial contract before soliciting feedback. Still, he said, the agency plans to go through the proper process.

“I think a lot of people got afraid because we hired a contractor to do a design-build process,” Goins said. “That doesn’t mean that the design, and the engineering, and the permitting, the consultation that comes with that process, is ignored. It is not.”

That answer didn’t appear to satisfy lawmakers.

“When you talk about there being controversy and welcoming the dialog, it doesn’t seem to jive with the fact that dollars are already dedicated towards this project,” said Committee Co-Chair Ashley Carrick, D-Fairbanks.

Lawmakers also grilled Goins and DOT Commissioner Ryan Anderson over concerns that the project stands to benefit private interests more than the communities that rely on the ferry system to get to Juneau for health care, groceries, air travel and more.

The new terminal is expected to benefit Grande Portage Resources’ proposed New Amalga Gold Project, which would likely use Cascade Point as its logistical base. But the terminal would also serve as a boon to Goldbelt Native Corporation, which owns the land.

“It feels very strongly to me like what’s really happening is Goldbelt is the primary beneficiary of a project the state is going to utilize federal dollars to support,” Carrick said.

Anderson, the agency’s commissioner, emphasized the importance of the private sector to the state’s economy and said working with industry can help promote economic development in Alaska.

Other lawmakers pressed agency officials over a controversial economic analysis of the project and about uncertainty around the new terminal’s overall cost and whether it would actually generate significant savings for the state.

Southeast ferry riders call proposed Cascade Point terminal a ‘boondoggle’ in public comments

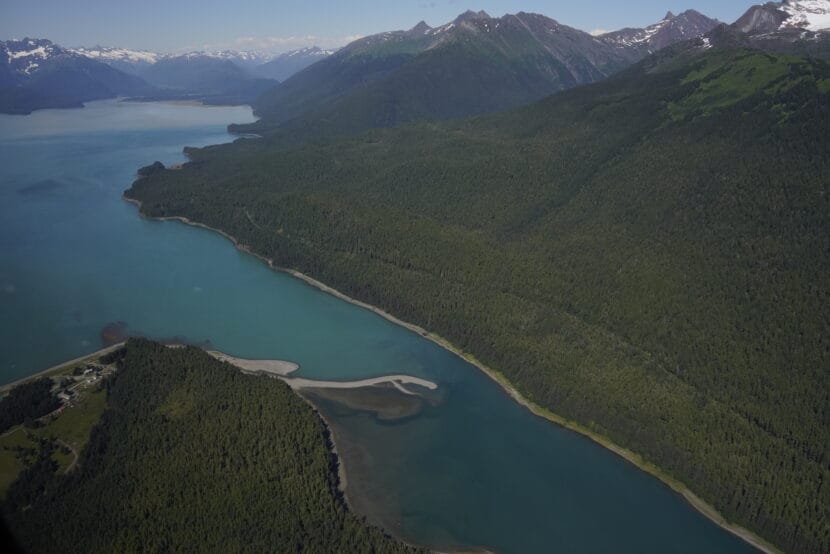

An aerial view of Berners Bay, where the state is proposing to build the Cascade Point Ferry Terminal. (Photo by Alix Soliman/KTOO)
An aerial view of Berners Bay, where the state is proposing to build the Cascade Point Ferry Terminal. (Photo by Alix Soliman/KTOO)

More than 90% of the comments submitted to the state reject the Cascade Point ferry terminal proposed in Juneau. Many of the comments opposing the project suggest the purported benefits to ferry passengers are disingenuous, and the project looks instead like a fast-tracked subsidy for mining companies.

Dozens of commenters said that the public process to approve this project is lacking, with the comment period and a highly criticized economic analysis coming after the state already signed a $28 million contract for the first phase of construction, set to begin this summer.

The plan includes developing an access road from the end of Glacier Highway north to the site — roughly 30 miles north of the existing Auke Bay Ferry Terminal — and a staging area for future construction.

Leaders in Skagway and Haines oppose the project. Members of the Alaska Marine Highway Operations Board have also questioned the motives behind it and said it doesn’t fit into their long-range plan for the Alaska Marine Highway System.

Public funds for private industry

The Juneau Assembly hasn’t taken an official stance on the state’s plan, but Assembly Member Maureen Hall wrote a comment objecting to it.

“I oppose the use of public funds to construct a remote State of Alaska ferry terminal when the facility’s apparent primary purpose is to function as an ore dock for private industry,” Hall wrote. “This represents a blatant misuse of public resources and raises serious concerns about the appropriateness and legality of such expenditures.”

Of the more than 500 comments opposing the project, a majority said the project would mainly benefit mining companies with holdings nearby and Goldbelt Native Corporation, which owns the land where the terminal would be built. Thirty-three commenters called the project a “boondoggle” outright, including Juneau resident Bjorn Wolter.

“There is just no reason at all to build a new terminal,” Wolter wrote. “This project has all the potential to be another South Mitkof or Coffman Cove boondoggle.”

Those ferry terminals on Mitkof Island and Prince of Wales Island cost millions of dollars. They were built far from the population centers they were meant to serve and close to logging sites 20 years ago. Two years after they were built, the Inter-Island Ferry Authority stopped running routes to them, and both have since sat unused

The Cascade Point ferry terminal stands to benefit the New Amalga gold mine proposed near the face of Herbert Glacier by Grande Portage Resources Ltd., a Canadian company. In December, Grande Portage announced that it is working with Goldbelt to design an ore barge dock alongside Cascade Point.

Ian Klassen, president and CEO of the company, was one of the 49 people who commented in favor of Cascade Point. He wrote that the plan will “create possibilities that currently do not exist north of Juneau for the reliable movement of cargo and commerce.”

Steve Ball, general manager of Coeur Alaska’s Kensington Mine, located across Berners Bay from the proposed site, also wrote in favor.

“The twice-daily boat trips to the Kensington Mine would depart from the new Cascade Point Ferry Terminal, resulting in reduced risk for our workforce, contractors, and visitors by shortening the distance of the boat run and exposure to the Upper Lynn Canal,” Ball wrote.

Coeur Alaska contracts with Goldbelt to transport miners to Kensington, mainly from Yankee Cove and from Echo Cove during inclement weather.

Ferry users weigh-in

The state has been pushing for the new terminal for several years and has said it would benefit travelers in Southeast by reducing operating costs and travel time between Juneau, Haines and Skagway.

But hundreds of commenters said building a second terminal in Juneau doesn’t solve the problems that the Alaska Marine Highway Service faces, including an aging fleet, crew shortages, reduced sailings and a lack of funding to address those issues.

Robin Ross is treasurer for the Organized Village of Kake, the tribal government for the village, and secretary for the Kake City School District. She commented that the project fails to address ongoing transportation needs in Southeast. She said a ferry cancellation disrupted a mammogram van service that provides cancer screenings for women there, and while flights were arranged for some women, not all were able to travel.

“The unfortunate reality is that a recent breast cancer diagnosis in October may have been

detected sooner had the ferry service not been canceled in May,” Ross wrote. “The ferry service serves as a critical lifeline.”

DOT’s FAQ page says, “terminal projects like Cascade Point are a critical step toward a stronger, more resilient system while new vessels are planned and funded through separate processes.”

But members of the Alaska Marine Highway Operations Board told the Anchorage Daily News that the project has been foisted upon AMHS and will create operational challenges they have to deal with. Last year, Gov. Dunleavy vetoed state legislators’ plan to divert funding from Cascade Point.

Southeast residents said that while a ferry ride from Juneau to Haines might be shorter, the burden will be placed on drivers and walkers to get to and from the new terminal, which is much farther from the city center. The city bus system already does not extend to the Auke Bay ferry terminal — it’s about a two-mile walk along the highway shoulder from the last stop.

Sean Powell, a current AMHS crew member, commented that commuting to Cascade Point would be much more difficult. “The increased distance, combined with weather conditions and other unforeseen disruptions, would add unnecessary challenges for crew members,” he wrote. “I believe funding would be better spent improving our existing infrastructure.”

Emily Mesch drives for rideshare services in Juneau during the summer and commented that it’s already difficult to make money driving people to the Auke Bay ferry terminal since it’s not centrally located. “I would never pick up a passenger there,” she wrote of the Cascade Point location, “unless the fares were about as high as a ferry ride, itself.”

According to the Alaska Department of Transportation, Goldbelt has committed to running a shuttle service from Cascade Point to Auke Bay and the Mendenhall Valley, but hasn’t set a ticket price yet.

DOT said that increasing snow plow service along Glacier Highway would cost about $30,000 if ferries operate out of Cascade Point in the winter. But after back-to-back snowstorms slammed Juneau this winter, some commenters said they’re not confident that plow service would be reliable.

“DOT and the city are both overwhelmed when we get snow, let alone the storms that have hit at the end of December and into January,” wrote Morgan Ramseth. “Placing necessary services at the end of a poorly maintained road seems completely out of touch with reality.”

Others said increasing traffic farther out the road would stretch the city’s emergency services thin.

The comment period for the first phase of the project ended on Jan. 9. The Alaska House Transportation Committee will hold a hearing with the Alaska Marine Highway Operations Board and DOT on Thursday, Feb. 5 at 1:30 p.m.

Alaska’s ferry system could run out of funding this summer due to ‘federal chaos problem’

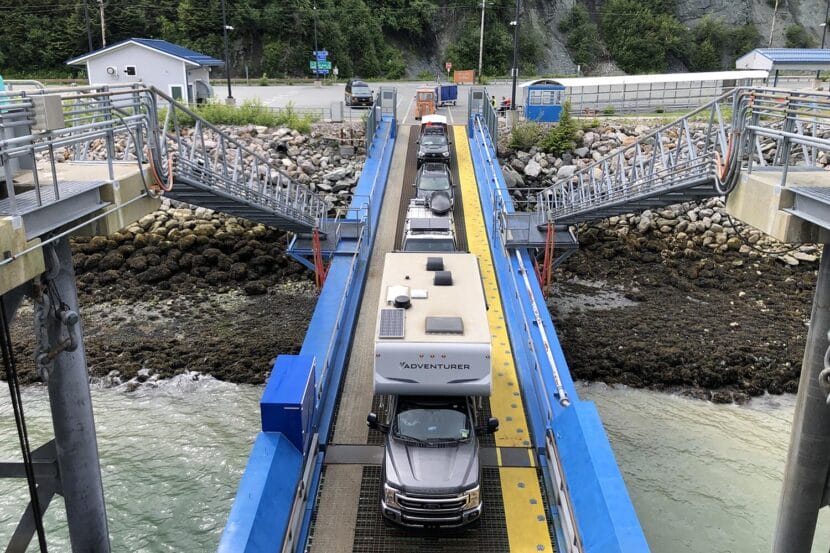

Cars drive aboard the Alaska Marine Highway System ferry Hubbard on June 25, 2023, in Haines.
Cars drive aboard the Alaska Marine Highway System ferry Hubbard on June 25, 2023, in Haines. (James Brooks/Alaska Beacon)

Alaska’s state ferry system is at risk of a partial or total shutdown this summer due to the failure of the federal government to issue a key annual grant.

“Currently right now, we have a shortfall in our budget,” said Dom Pannone, director of program administration and management for the Alaska Department of Transportation and Public Facilities, to members of the Senate Finance Committee during a Monday morning hearing.

Money from the Federal Transit Administration’s rural ferry program pays for almost half of the Alaska Marine Highway System’s operating expenses, but the administration failed to open its annual grant process in fiscal year 2025, which ended Sept. 30.

The ferry system’s budget runs according to the calendar year. Last spring, the Alaska Legislature and Gov. Mike Dunleavy budgeted $171 million for the 2026 ferry budget. Of that, almost $78 million was supposed to come from the rural ferry program.

Without that money, the system could be forced to tie up its ships in midsummer, at the peak of the state’s annual tourist season.

“Right now, we have a federal chaos problem,” said Sen. Jesse Kiehl, D-Juneau and a member of the Senate Finance Committee.

Ryan Anderson, commissioner of the state DOT, said his agency is “looking at several options” to prevent a shutdown of the ferry system.

If a federal grant isn’t delivered, DOT would make significant changes to the summer ferry schedule, which is slated to begin in May.

Anderson said the state could “dispose of the Matanuska,” the state’s oldest active ferry, which has been tied up dockside as a “hotel ship” because of maintenance costs.

The ferry Kennicott, coming out of drydock, or the Columbia, another old mainline ferry, could be tied up as a hotel ship instead of the Matanuska, he said.

On Monday, neither DOT officials nor state legislators could say why the Federal Transit Administration has failed to make grants available.

“What is going on in Washington, D.C.? That’s always a tough thing to work with,” Anderson said.

U.S. Sen. Lisa Murkowski, R-Alaska, secured almost $1 billion in the 2021 Infrastructure Investment and Jobs Act bill for the rural ferry program, which was written in a way to steer much of the money to Alaska.

By text after Monday’s hearing, Murkowski spokesman Joe Plesha said the Federal Transit Administration told her office it will release the FY26 ferry grants this spring but did not give a timeline.

“We are directly engaged with the FTA and working to advance the release of this grant funding as soon as possible,” Plesha said.

When Murkowski got the ferry language signed into law, it was the first time the federal government had significantly funded operational expenses for Alaska’s ferry system.

“In this particular case, it can actually pay for the operations of those (ferry) vessels,” Anderson said, noting that includes operating costs like crew and fuel. That billion dollars was to be spread across five years, and the program disbursed more than $252 million nationwide in FY22, $170 million in FY23 and $194 million in FY24.

Alaska received more than five-sixths of the total distribution in that time, something that allowed Gov. Mike Dunleavy to divert state dollars to other parts of Alaska’s annual budget.

Alaska DOT estimates that about $410 million remains available for the federal government to disburse.

In each of the three prior grant years, it took between 152 and 199 days from the time the grant application period opened to the time the grant was awarded.

That timeline means that even if federal transit officials were to open the grant process tomorrow, a decision might not be made before the start of the summer ferry schedule in May.

Dunleavy and the Legislature could extend the timeline by changing the ferry system’s budget calendar so that it starts July 1 along with all other state agencies, but if there’s still no federal money, that would just extend operations until January 2027, and then the system would face a $150 million cliff instead of a $78 million one.

Sen. Bert Stedman, R-Sitka, said that finding “backfill” money will be difficult in either case.

“Our budgets are getting tighter and taking away the flexibility the (finance) committee has to backfill some of these holes, and this particular hole could be significant, pushing $80 million,” he said.

The ferry funding issue could persist even if the federal transit authority resumes paying grants, because its ferry operations program is set to expire this year.

“What happens when that grant money is gone?” asked Sen. Mike Cronk, R-Tok.

“This year, the surface transportation reauthorization is up for renewal,” Anderson said. “This, we understand, is part of that discussion: Will the rural ferry program continue over the next subsequent four years?”

Anderson said that even if Congress renews the program, the current Alaska-favorable rules might be rewritten.

“Other states are very interested in this program as well because they have a lot of similar challenges,” he said. “Nationwide, there’s support for a program such as this. The questions that are out: How will the rules be rewritten, and how competitive will the program be? That will be the challenge.”

Tustumena replacement project out to bid, new ferry to sail in 2029

A computer-generated mockup of the new Tustumena replacement vessel, which will be bigger, carry more people and vehicles as well as be more efficient.
A computer-generated mockup of the new Tustumena replacement vessel, which will be bigger, carry more people and vehicles as well as be more efficient. (Alaska Marine Highway System)

After years of delays, the build contract to replace the Alaska Marine Highway System’s ferry Tustumena is out to bid. The state’s project notice calls for the new mainliner ferry to be completed by the beginning of 2029 with an estimated price tag of more than $300 million.

The new ferry will be a more efficient, diesel-electric vessel with capacity for 250 passengers and 58 cars at a time.

“It is really delightful, even just to talk about. You can probably hear the smile on my face,” Louise Stutes said.

State Representative Stutes, a Republican from Kodiak, is a longtime advocate of the Alaska ferry system. Especially the more than 60-year-old Tustumena, which regularly sails from Homer to Kodiak Island communities.

Captain John Mayer (left) of the M/V Tustumena presented Rep. Louise Stutes (right) a hand painted piece of the Tustumena’s hull for her longtime support of the Alaska Marine Highway System in August of 2024. (Brian Venua/KMXT)

She commended Craig Tornga, the head of the state ferry system, for getting the Tustumena replacement project to this point.

“And there are several shipyards that are interested in it as opposed to the first time it went out where no shipyards were interested,” she said.

Gov. Mike Dunleavy first announced the project in 2021. The initial build contract went out to bid in 2022 – and no bids came in.

“So, they kind of had to reassess it, redesign a few things and we’re good to go,” Stutes said.

Tornga went back to the drawing board on the ferry’s design and overhauled the contract over the last several years. Tornga has previously said that one of the hurdles that delayed the project so long was a requirement that 70% of the money spent on the Tustumena replacement has to go to American companies.

Bidding closes May 28 according to the state’s public notice for the project.
